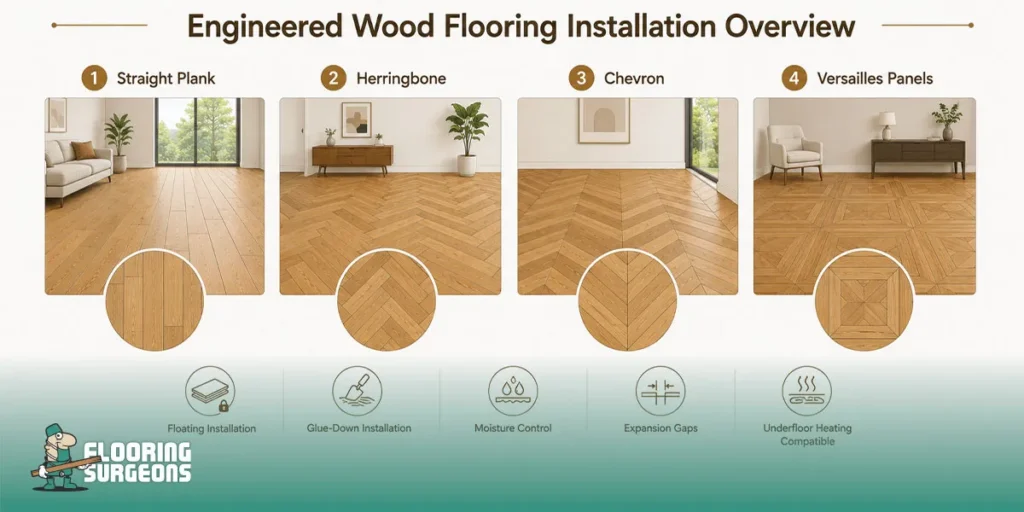

Engineered Wood Flooring Installation Overview
| Item | Details |
|---|---|
| Difficulty | Beginner to Advanced |
| Installation Methods | Floating, Glue-Down, Nail-Down |
| Suitable Rooms | Living Rooms, Bedrooms, Hallways |
| Acclimatisation | 48–72 Hours |
| Expansion Gap | 10–15 mm |
| Subfloor Requirement | Clean, Dry & Level |
| Underfloor Heating | Compatible (if approved) |
Before You Start
✔ Subfloor is clean, dry and level
✔ Moisture levels checked
✔ Flooring acclimatised for 48–72 hours
✔ Expansion gaps planned
✔ Correct underlay or adhesive selected
Engineered wood flooring combines the appearance of real wood with improved stability and durability through its multi-layer construction.
This guide explains how to install engineered wood flooring step by step, including straight plank, herringbone, chevron and Versailles panel layouts. Straight plank flooring is generally more beginner-friendly, while herringbone, chevron and Versailles installations require more precise layout planning, alignment and cutting.

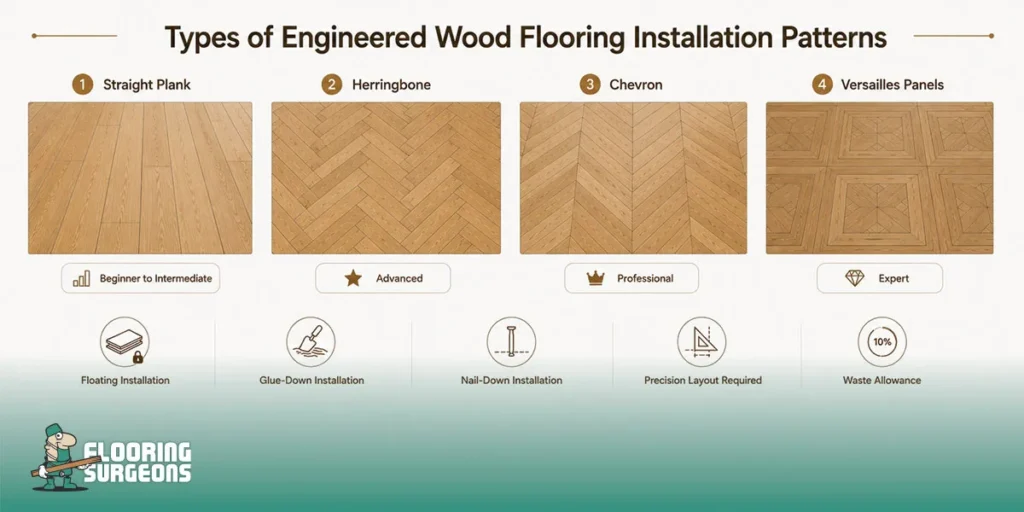

Types of Engineered Wood Flooring Installation Patterns
Different engineered wood flooring patterns require different installation methods, layout planning and levels of installation accuracy.
While straight plank flooring is generally more suitable for DIY installation, decorative layouts such as herringbone, chevron and Versailles panels require more precise alignment and professional installation techniques.

| Pattern | Difficulty | Recommended Installation | Layout Precision | Waste Allowance | DIY Suitable |
|---|---|---|---|---|---|
| Straight Plank | Beginner to Intermediate | Floating / Glue-Down / Nail-Down | Moderate | 5–8% | Yes |
| Herringbone | Advanced | Full Glue-Down | High | 10–15% | Limited |
| Chevron | Professional | Full Glue-Down | Very High | 12–18% | No |
| Versailles Panels | Expert | Full Glue-Down | Extremely High | 15–20% | No |

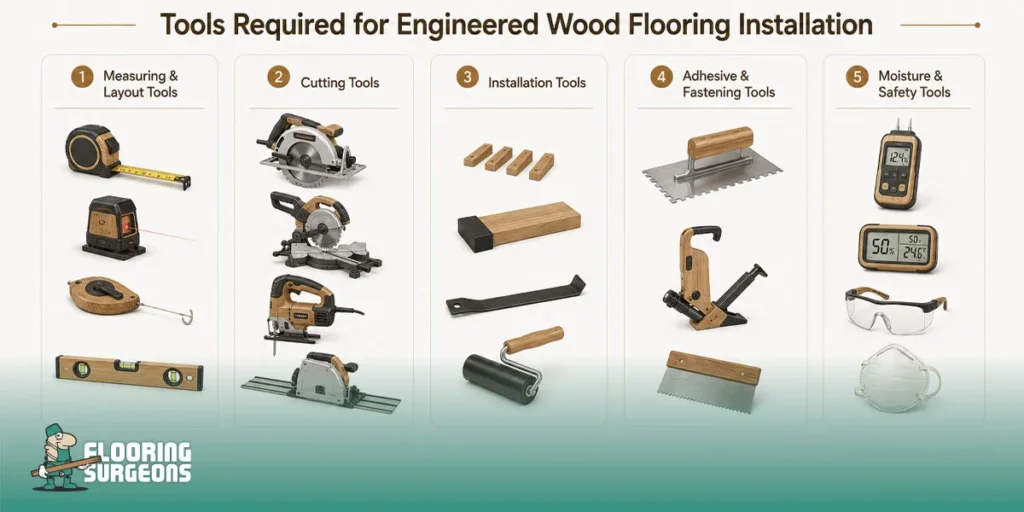

Tools Required for Engineered Wood Flooring Installation
Different engineered wood flooring patterns and installation methods require different measuring, cutting and installation tools.
Decorative layouts such as herringbone, chevron and Versailles panels require more precise alignment and cutting equipment than standard straight plank installations.

Measuring & Layout Tools
| Tool | Main Use |
|---|---|
| Tape Measure | Room and board measurements |
| Laser Level | Centre-line and layout alignment |
| Chalk Line | Reference layout lines |
| Spirit Level | Subfloor flatness checks |
| Framing Square | Angle accuracy |
| Straight Edge | Detect uneven subfloors |
Cutting Tools
| Tool | Main Use |
|---|---|
| Circular Saw | Straight board cuts |
| Mitre Saw | Precision angled cuts |
| Jigsaw | Pipes and irregular cuts |
| Track Saw | Long straight cuts |
| Utility Knife | Underlay trimming |
| Fine-Tooth Blade | Reduce veneer chipping |
Installation Tools
| Tool | Main Use |
|---|---|
| Flooring Spacers | Expansion gaps |
| Rubber Mallet | Secure board fitting |
| Tapping Block | Tighten joints |
| Pull Bar | Final row installation |
| Suction Lifters | Position large panels |
| Floor Roller | Adhesive transfer |
Adhesive & Fastening Tools
| Tool | Main Use |
|---|---|
| Notched Trowel | Adhesive application |
| Adhesive Spreader | Consistent coverage |
| Flooring Nailer | Nail-down installation |
| Flooring Stapler | Staple-down installation |
| Adhesive Cleaner | Remove excess adhesive |
| Moisture-Resistant Adhesive | Flexible board bonding |
Moisture Testing & Safety Tools
| Tool | Main Use |
|---|---|
| Moisture Meter | Test subfloor moisture |
| Hygrometer | Measure room humidity |
| Infrared Thermometer | Check UFH temperatures |
| Knee Pads | Installation comfort |
| Safety Glasses | Eye protection |
| Dust Mask | Dust protection |
Professional Installer Tips
✔ Use fine-tooth saw blades to reduce veneer chipping.
✔ Check laser and chalk-line alignment regularly during installation.
✔ For glue-down installations, work in small sections for better adhesive control.
Preparing the Subfloor for Engineered Wood Flooring
A clean, level and moisture-controlled subfloor is essential for successful engineered wood flooring installation.
Decorative layouts such as herringbone, chevron and Versailles panels require especially accurate subfloor preparation to maintain alignment and long-term stability.
Cleaning the Subfloor
Before installation, remove all contaminants that may affect board stability or adhesive bonding.
Remove:
✔ Dust and dirt
✔ Old adhesive residue
✔ Paint or plaster debris
✔ Grease and surface contaminants
✔ Loose construction waste
Vacuum the entire subfloor thoroughly before moisture testing or levelling work begins.
Checking Subfloor Flatness
The subfloor must be level and structurally stable before installation.
Check for:
✔ High spots
✔ Low areas
✔ Surface dips
✔ Uneven room transitions
Self-levelling or smoothing compounds may be required to achieve the correct flatness tolerance.

| Flooring Pattern | Maximum Subfloor Tolerance |
|---|---|
| Straight Plank | 3 mm over 2 metres |
| Herringbone | 2 mm over 2 metres |
| Chevron | Maximum 2 mm over 2 metres |
| Versailles Panels | SR1 / perfectly level subfloor |

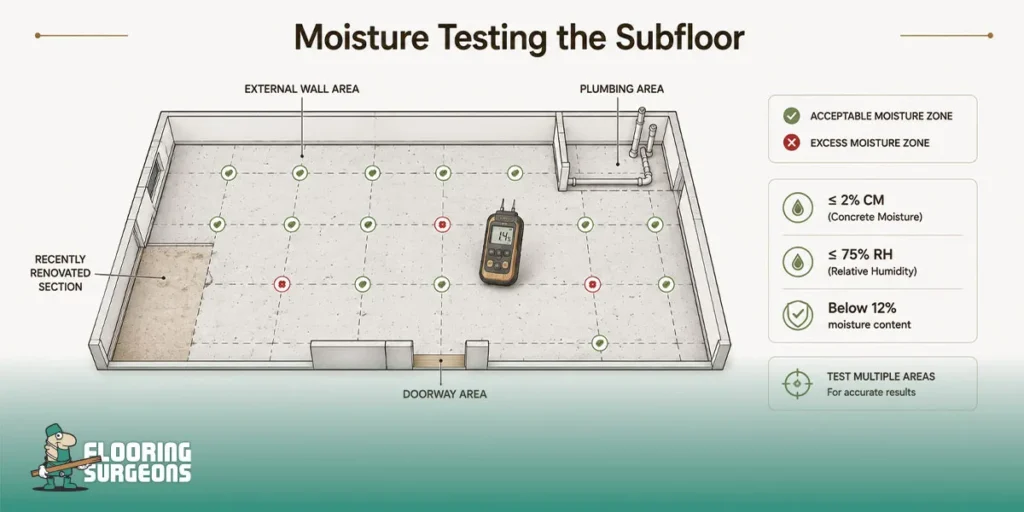

Moisture Testing the Subfloor
Excess moisture can cause engineered wood flooring to expand, cup or fail after installation.
Typical moisture limits:
✔ Concrete subfloors: ≤ 2% CM or ≤ 75% RH
✔ Timber subfloors: Below 12% moisture content
✔ Anhydrite screeds: Follow manufacturer guidelines
Test multiple areas across the room, especially near external walls, plumbing areas and recently renovated sections.
⚠ Do not install engineered wood flooring until moisture levels are within acceptable limits.

Inspecting the Structural Condition of the Subfloor
The subfloor must be structurally stable before installation begins.
Check for:
✔ Cracked screeds or concrete
✔ Loose plywood sheets
✔ Timber subfloor deflection
✔ Weak levelling compounds
✔ Hollow areas beneath the surface
Repair unstable areas before flooring installation.

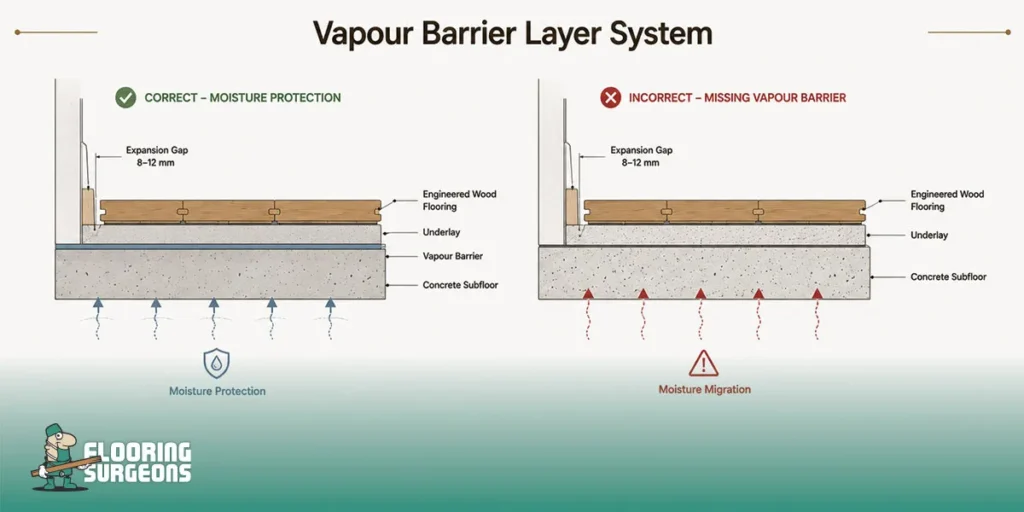

Installing a Vapour Barrier
Moisture protection is often required when installing engineered wood flooring over concrete subfloors.
Moisture-control systems may include:
✔ PE vapour membranes
✔ Liquid damp-proof membranes
✔ Moisture-resistant underlays
✔ Integrated vapour barrier systems

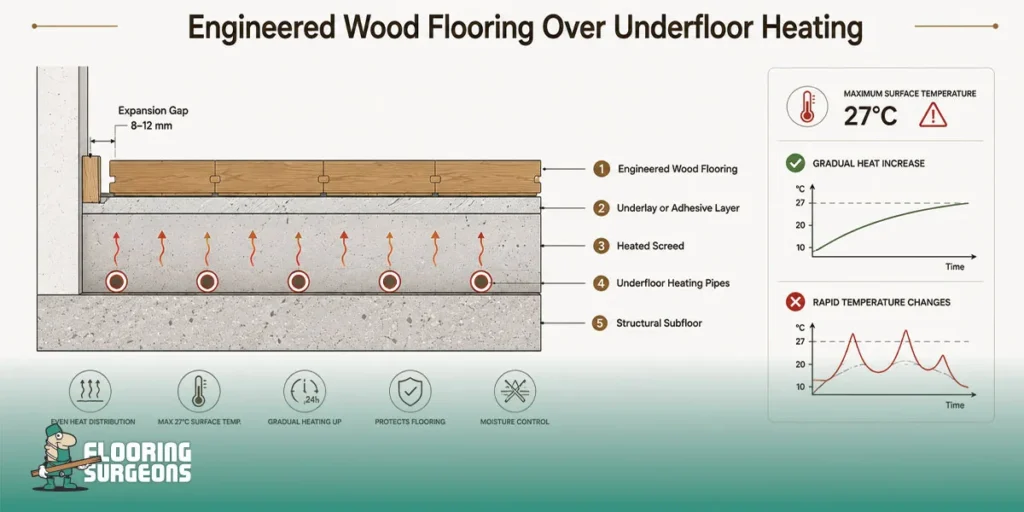

Underfloor Heating Preparation
Engineered wood flooring can be installed over underfloor heating systems when properly prepared.
Before installation:
✔ Complete a full heating cycle
✔ Switch heating off for 24 hours
✔ Confirm the subfloor is dry and stable
After installation:
✔ Increase temperature gradually
✔ Avoid rapid temperature changes
✔ Never exceed 27°C surface temperature

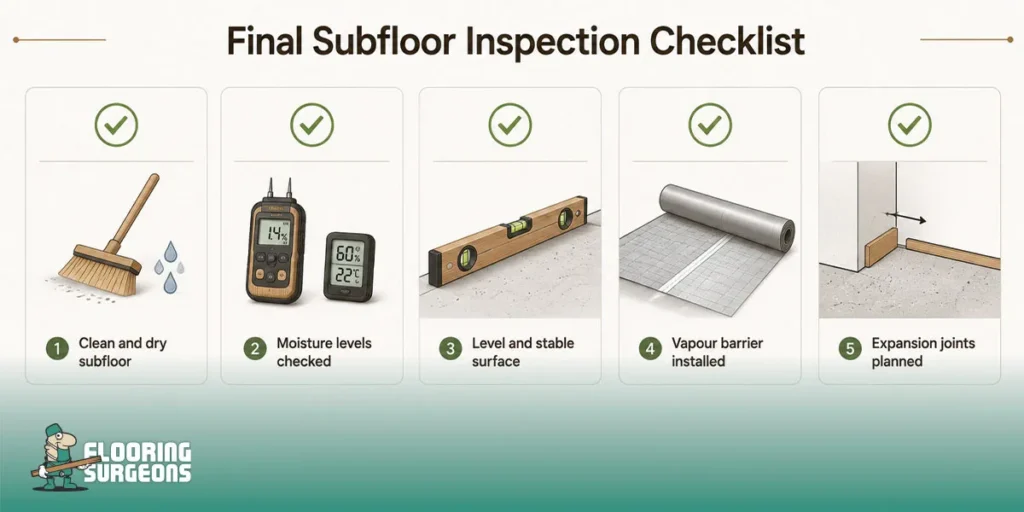

Final Subfloor Inspection Before Installation
Before installation begins, confirm that:
✔ The subfloor is clean and dry
✔ Moisture levels are acceptable
✔ The floor is level and stable
✔ Vapour barriers are installed correctly
✔ Expansion joints are planned where required

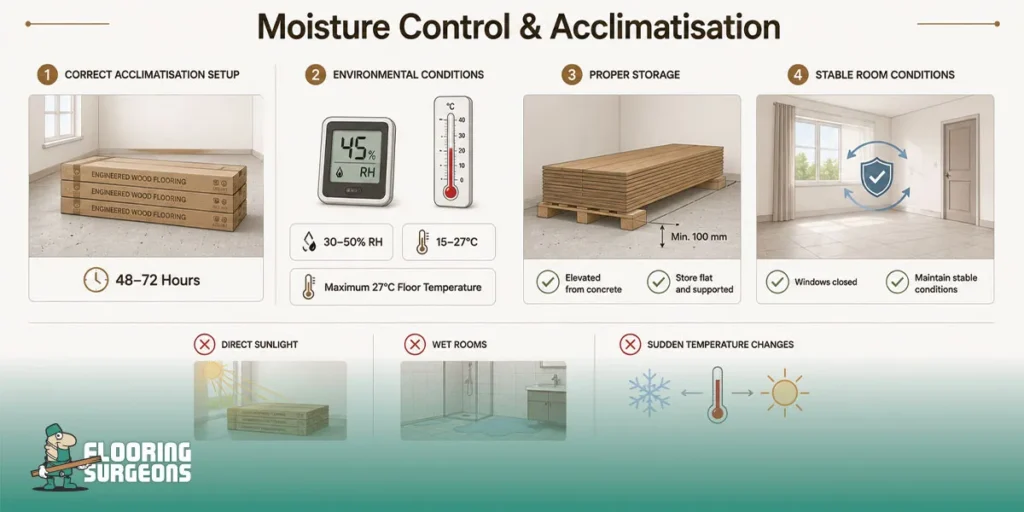

Moisture Control & Acclimatisation
Proper acclimatisation helps reduce board movement, joint stress and installation problems after fitting.

How to Acclimatise Engineered Wood Flooring
Before installation:
✔ Store flooring inside the installation room
✔ Keep boxes flat and horizontally stacked
✔ Do not place flooring directly on concrete
✔ Keep boards away from damp areas and direct sunlight
✔ Maintain closed job-site conditions
✔ Acclimatise flooring for 48–72 hours before installation
Recommended Room Conditions
| Condition | Recommended Range |
|---|---|
| Room Temperature | 15–27°C |
| Relative Humidity | 30–50% |
| Acclimatisation Time | 48–72 Hours |
| Maximum Floor Surface Temperature | 27°C |
Use a hygrometer to monitor room humidity levels before and during installation.
Important Acclimatisation Tips
✔ Keep the room temperature stable during installation
✔ Avoid sudden humidity or temperature changes
✔ Do not install flooring in wet or recently plastered rooms
✔ Open only a few flooring boxes at a time
✔ Check boards for visible damage before fitting

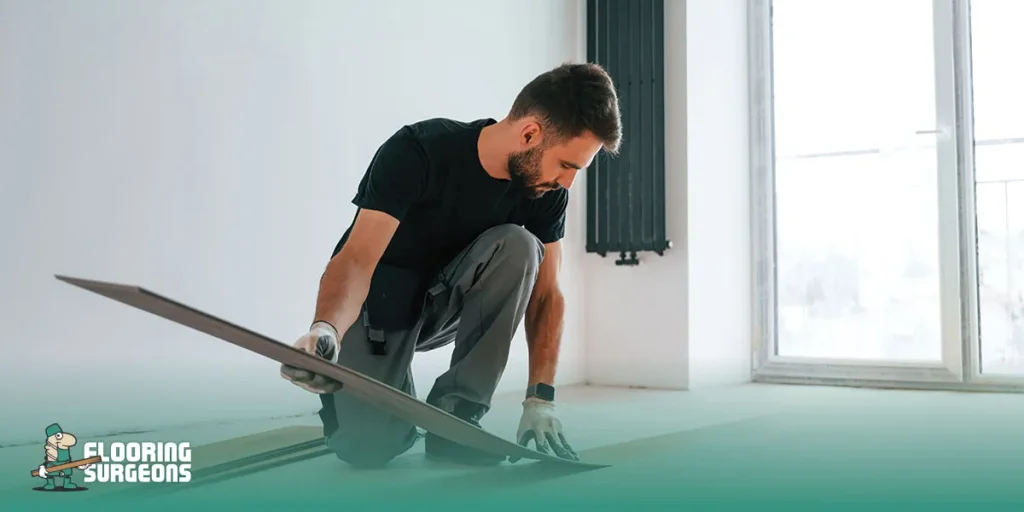

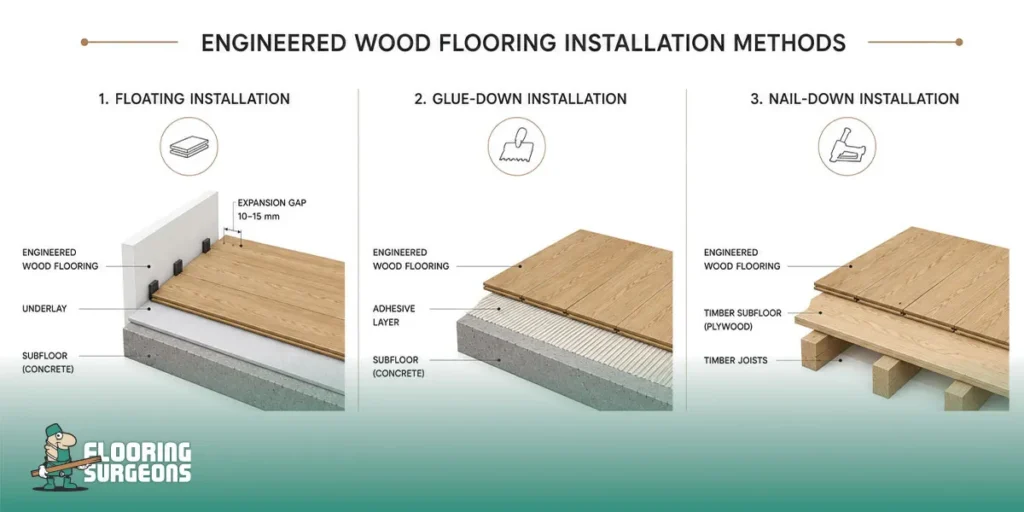

Choosing the Correct Installation Method
Different engineered wood flooring patterns and subfloor types require different installation methods. Straight plank flooring can often be installed using floating, glue-down or nail-down systems, while herringbone, chevron and Versailles panels are typically installed using full glue-down methods.
| Installation Method | Best For | Compatible Patterns | Main Advantage |
|---|---|---|---|
| Floating | Stable subfloors and DIY projects | Straight Plank | Faster installation |
| Glue-Down | Concrete subfloors and patterned layouts | Straight Plank, Herringbone, Chevron, Versailles | Maximum stability |
| Nail-Down | Timber subfloors | Straight Plank | Strong traditional fixing |
| Staple-Down | Timber subfloors | Straight Plank | Faster fixing method |

Recommended Installation Methods by Pattern
| Flooring Pattern | Recommended Installation Method |
|---|---|
| Straight Plank | Floating, Glue-Down or Nail-Down |
| Herringbone | Full Glue-Down |
| Chevron | Full Glue-Down Only |
| Versailles Panels | Full Glue-Down Only |
Chevron and Versailles layouts require extremely accurate alignment and are generally installed using full-spread adhesive systems for maximum stability and pattern consistency.
For floating installations, use a suitable underlay to improve floor support, sound insulation and moisture protection.

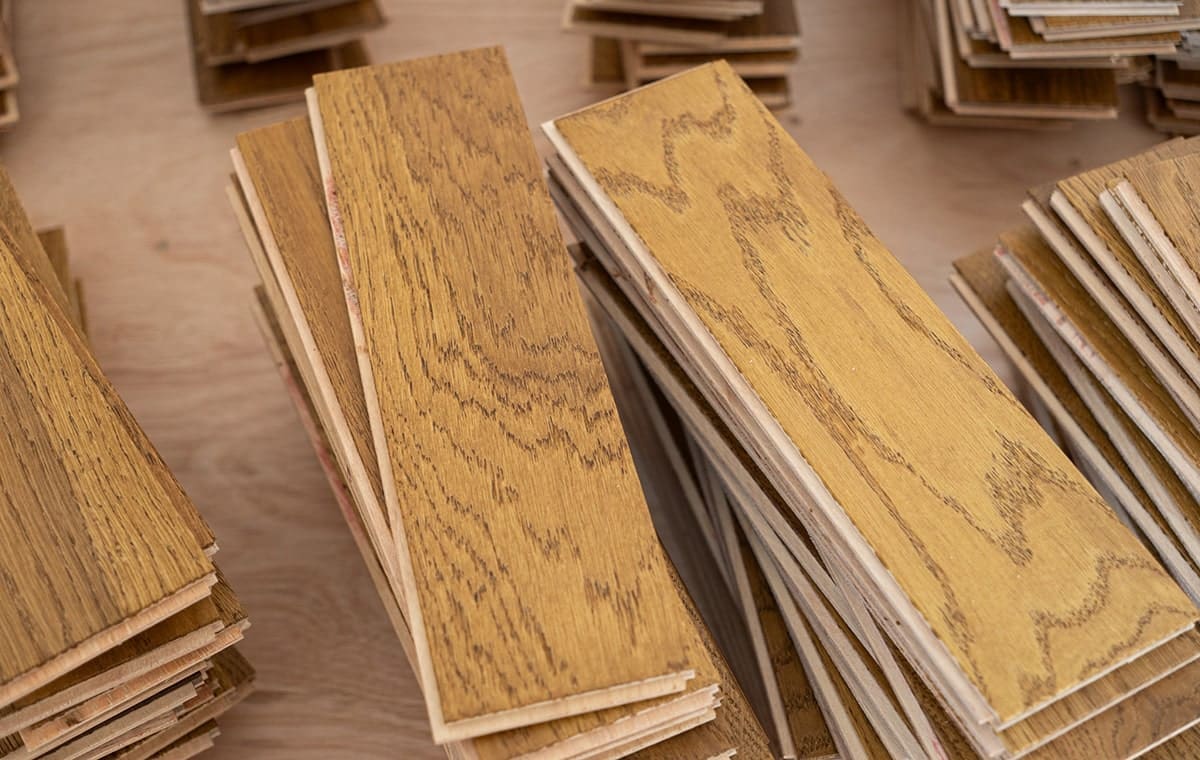

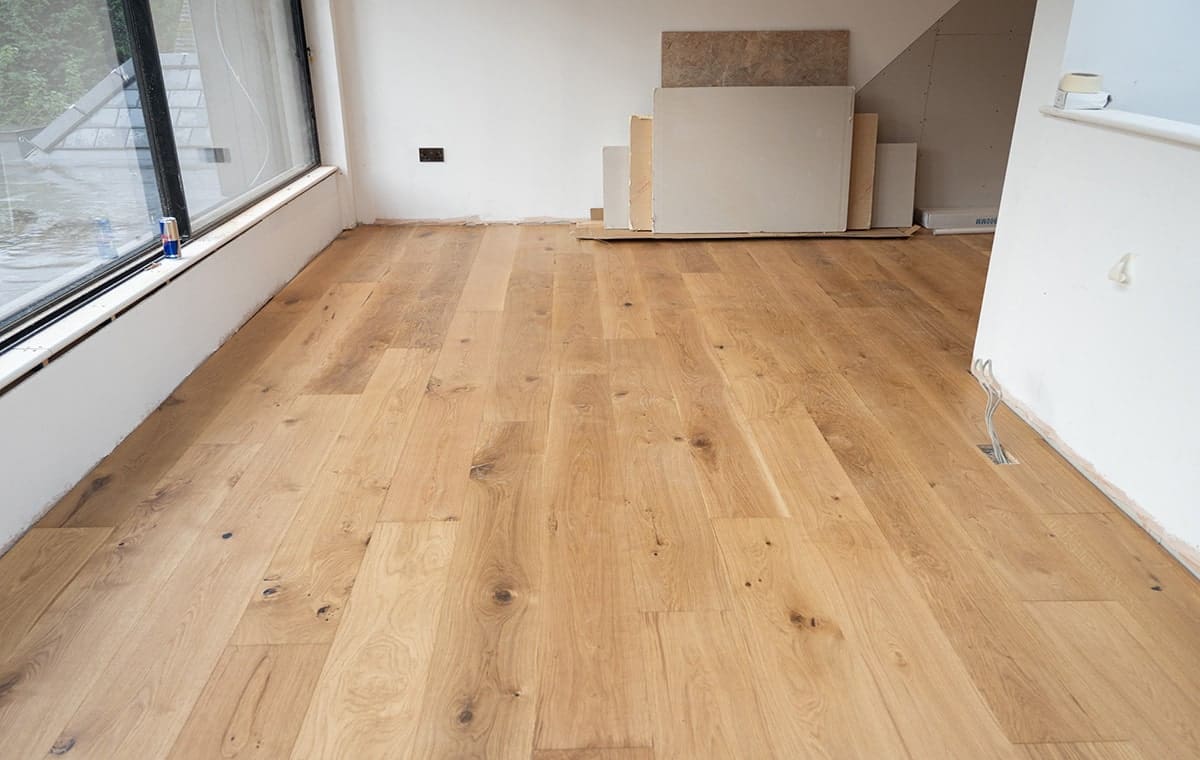

How to Install Engineered Straight Plank Flooring
Straight plank engineered wood flooring is the most installation-friendly engineered wood layout and can be installed using floating, glue-down or nail-down methods. Careful layout planning and consistent spacing help achieve a balanced and professional finish.

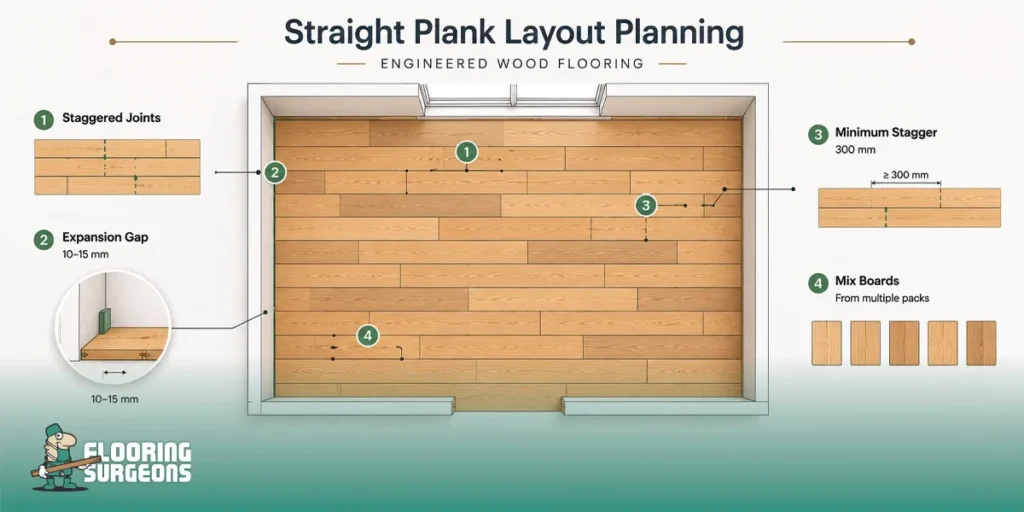

Step 1: Plan the Layout
Before installation:
✔ Dry-lay several rows to check board distribution
✔ Avoid narrow final rows where possible
✔ Blend boards from multiple packs for natural colour variation
✔ Stagger end joints by at least 150 mm
✔ Avoid repeating H-joint patterns

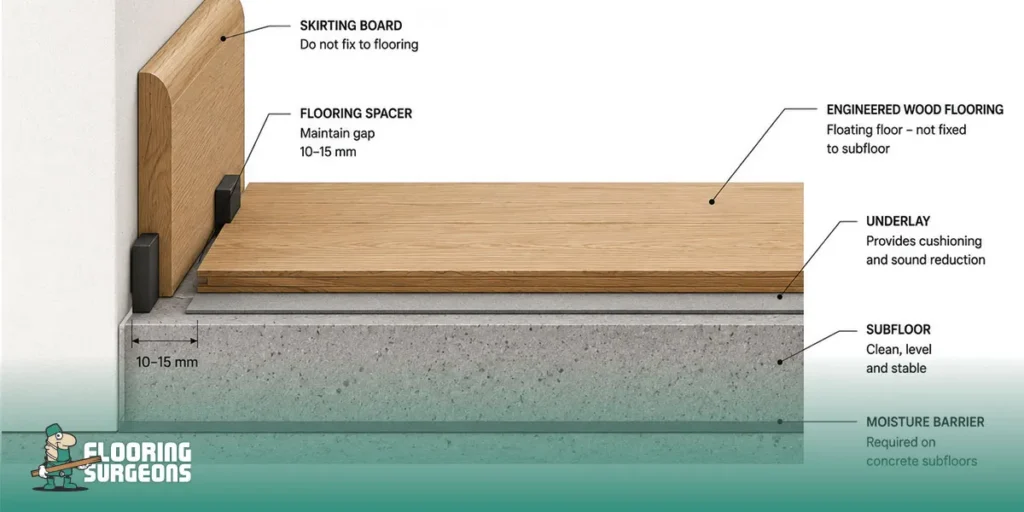

Step 2: Prepare Expansion Gaps
Leave expansion gaps around walls, pipes and fixed objects to allow natural floor movement.
✔ Typical expansion gap: 10–15 mm
✔ Larger rooms may require additional movement joints
✔ Use flooring spacers for consistent spacing

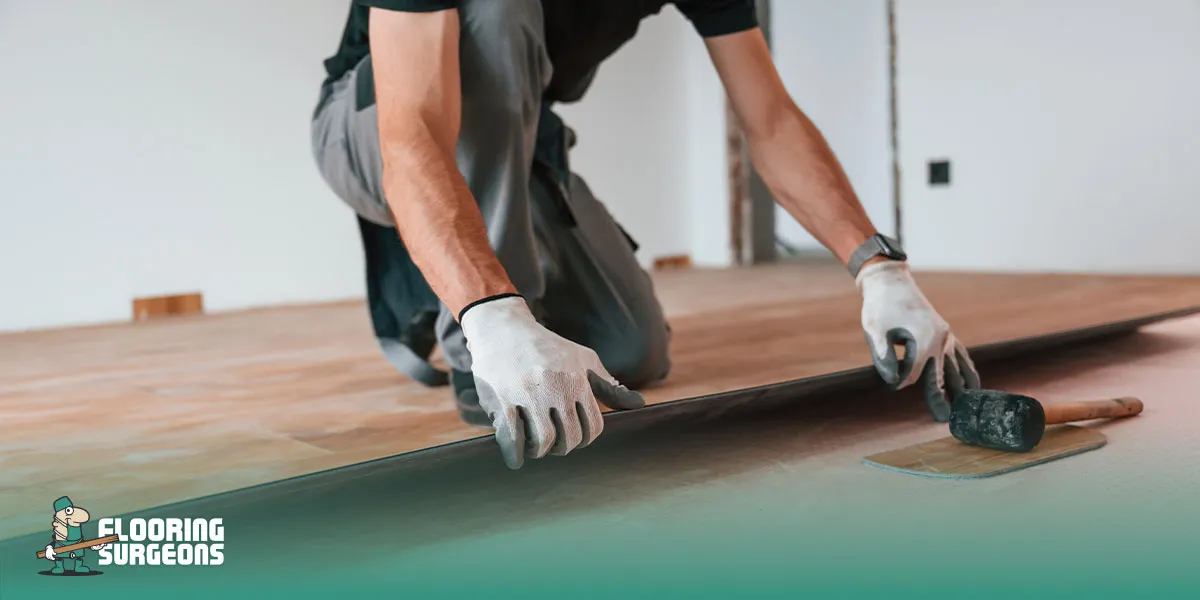

Step 3: Install Underlay or Adhesive

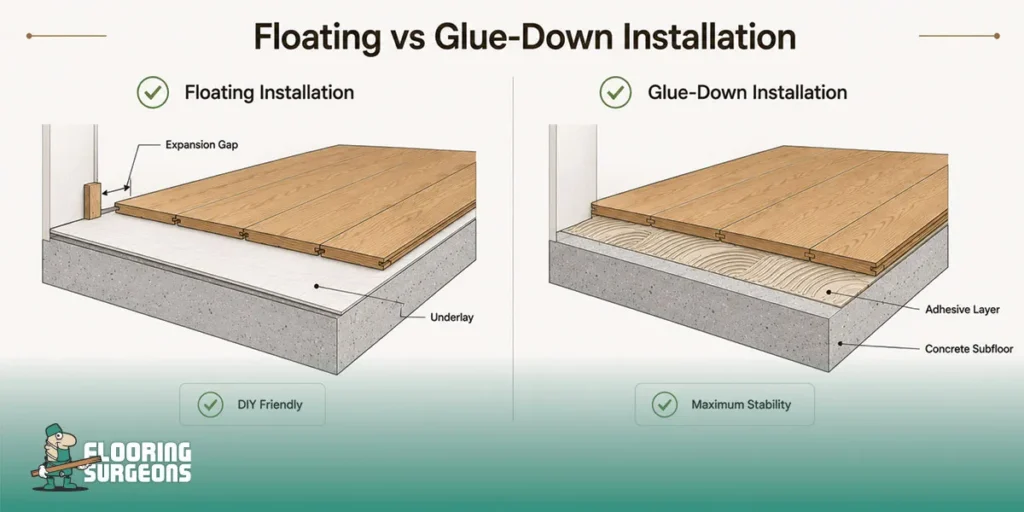

Installation preparation depends on the chosen fitting method:
✔ Floating floors: Install underlay or vapour barrier
✔ Glue-down floors: Apply adhesive evenly using a notched trowel
✔ Nail-down floors: Ensure the timber subfloor is stable before fixing
For glue-down installations, work in small sections to maintain adhesive control.

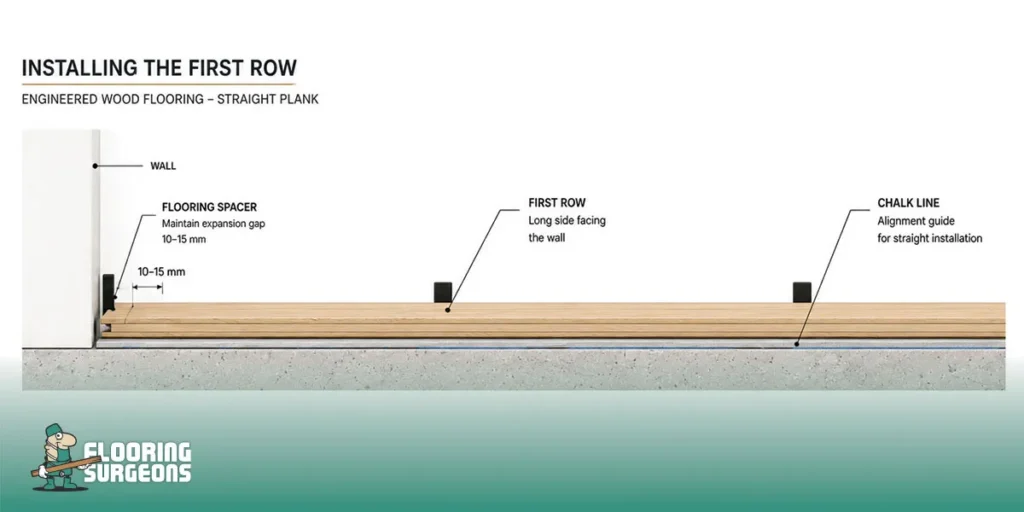

Step 4: Lay the First Row
✔ Start from the straightest wall
✔ Position the first row carefully
✔ Install spacers along the wall edge
✔ Keep joints tight and evenly spaced
✔ Check alignment regularly using a straight edge or chalk line

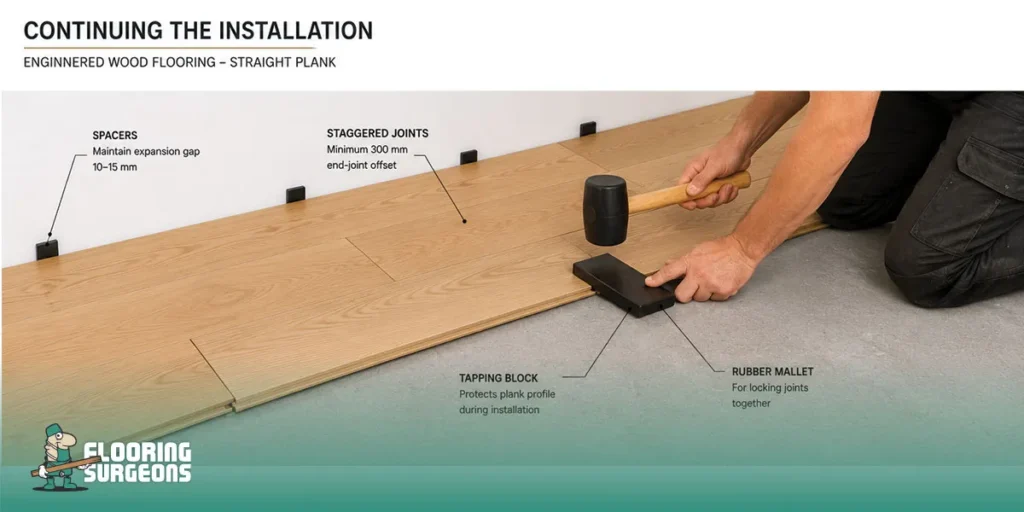

Step 5: Continue Installing the Boards
During installation:
✔ Check locking joints before securing boards
✔ Use a tapping block and rubber mallet where required
✔ Remove adhesive residue immediately
✔ Inspect boards for visible defects before fitting
✔ Avoid forcing boards together

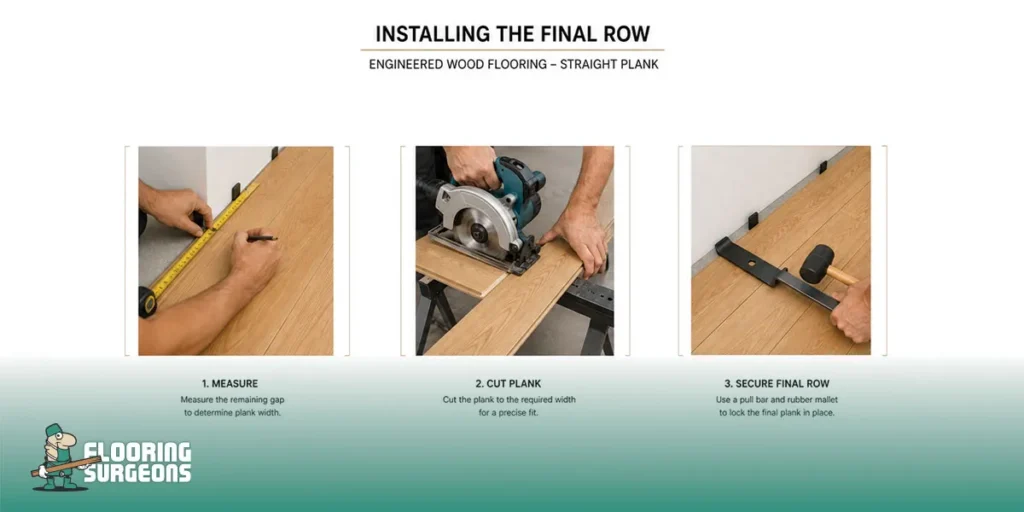

Step 6: Cut and Fit the Final Row
✔ Measure the remaining space carefully
✔ Maintain the required expansion gap
✔ Use accurate cutting tools
✔ Use a pull bar where necessary to secure the final row

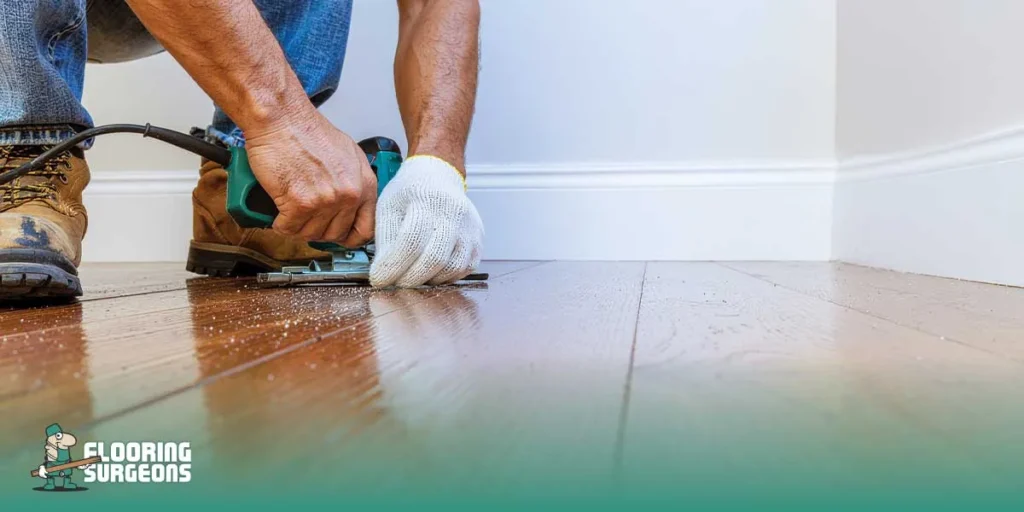

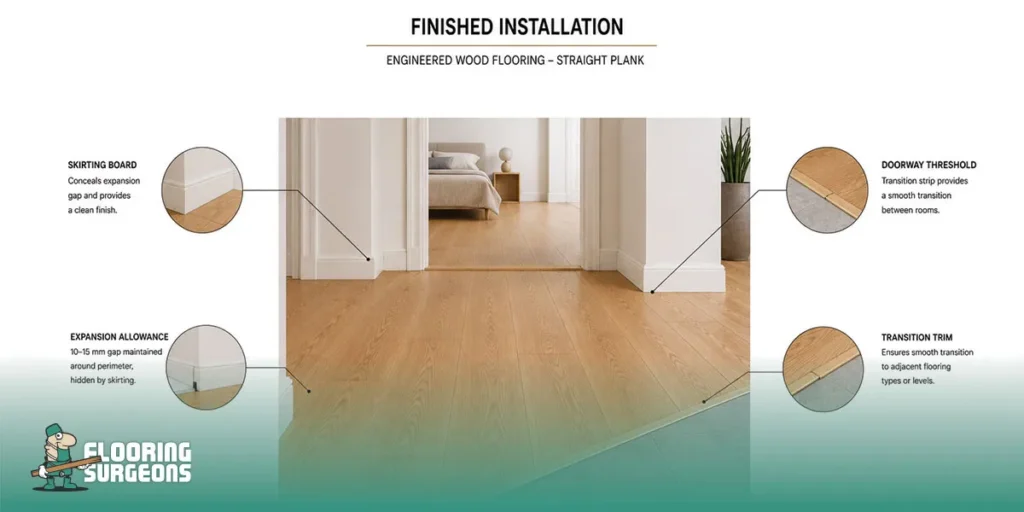

Step 7: Install Thresholds and Trims
After installation:
✔ Remove spacers
✔ Install skirting boards and transition trims
✔ Fit doorway thresholds where required
✔ Ensure trims do not restrict floor movement

Important Straight Plank Installation Tips
✔ Mix boards from several packs during installation
✔ Keep board rows visually balanced
✔ Avoid heavy traffic on freshly glued flooring
✔ Check row alignment regularly
✔ Remove dust and debris continuously

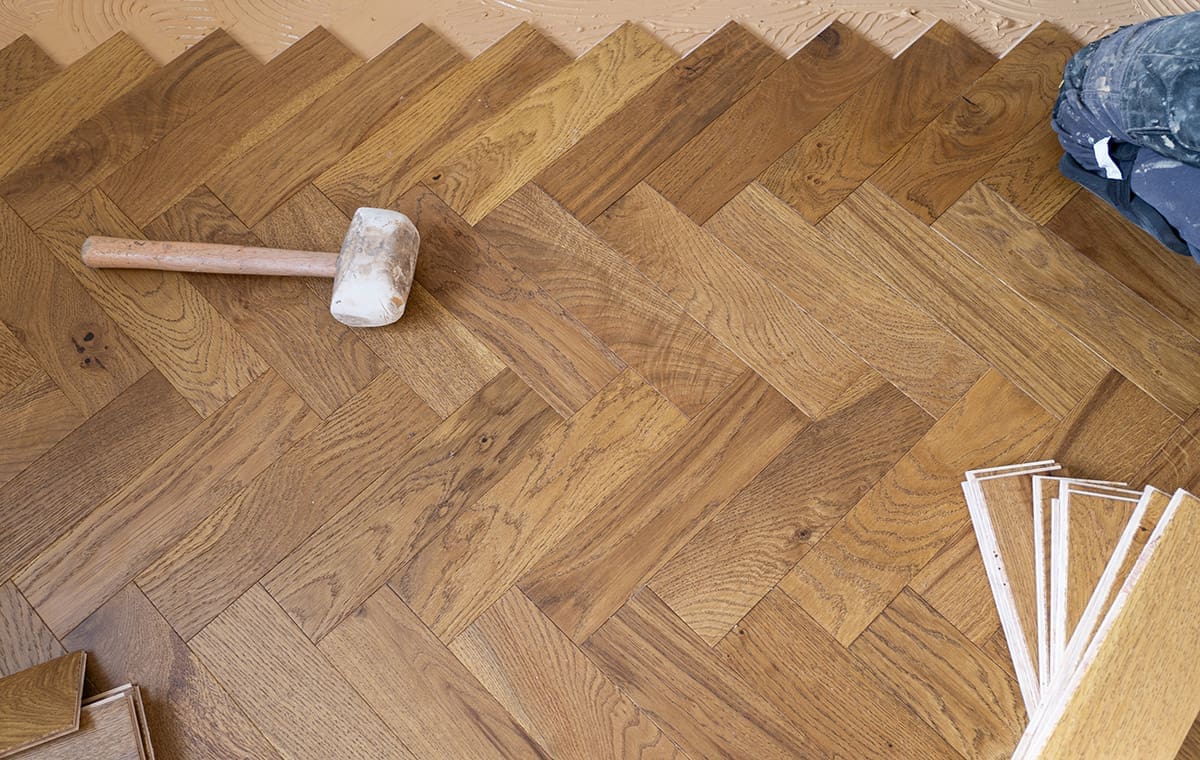

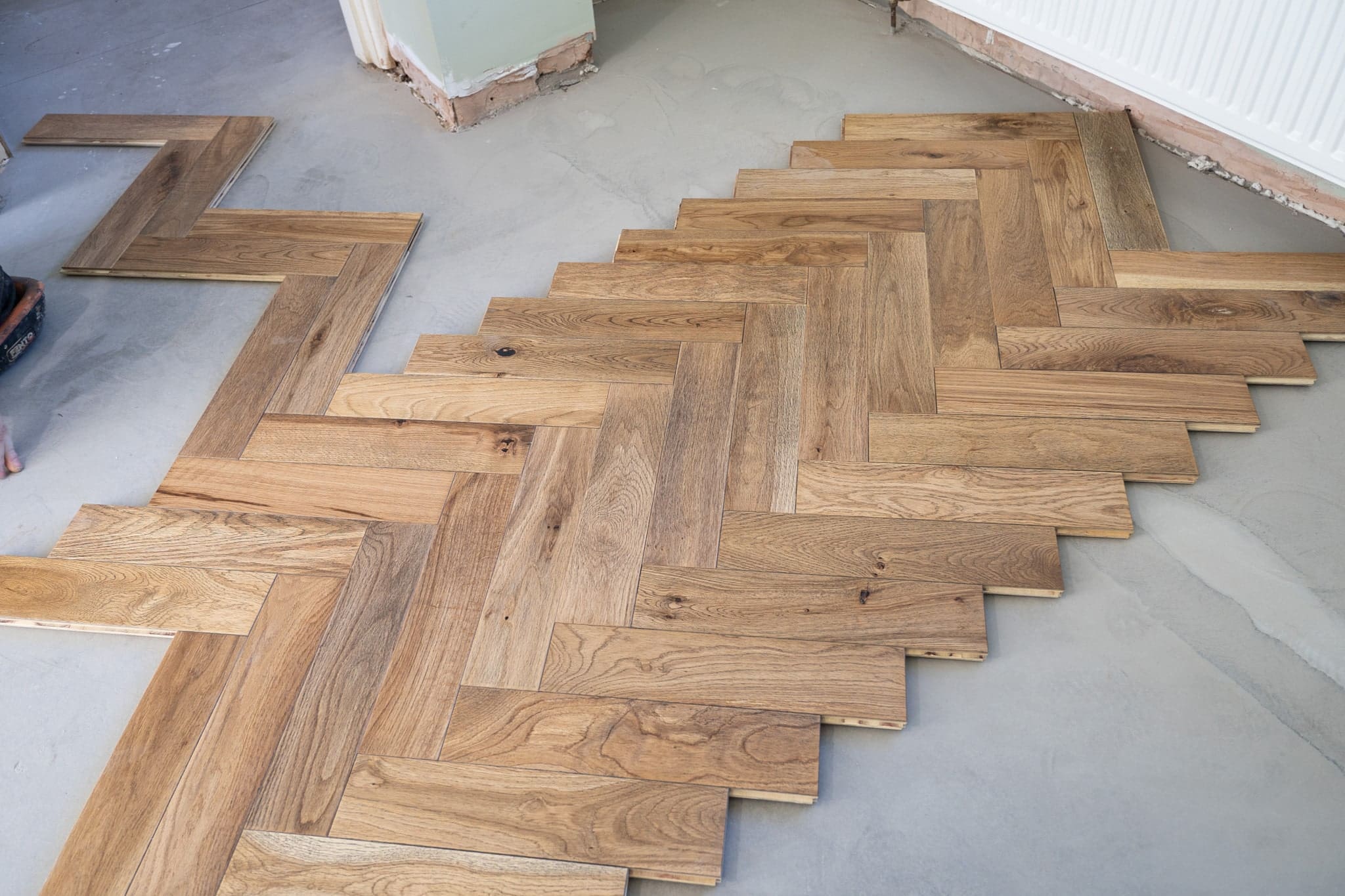

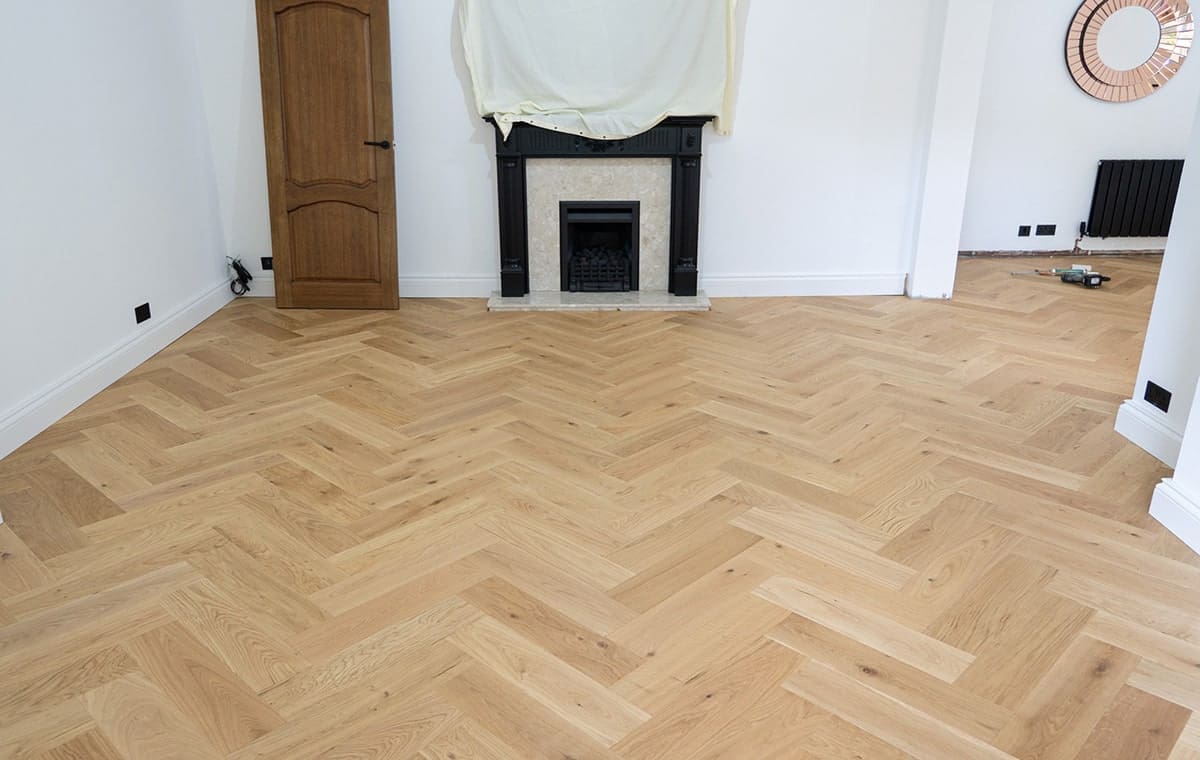

How to Install Engineered Herringbone Flooring
Engineered herringbone flooring requires accurate planning, precise alignment, and careful adhesive control to achieve a balanced and professional finish. Unlike straight plank flooring, herringbone layouts rely heavily on centre-line accuracy and consistent pattern positioning throughout the installation.

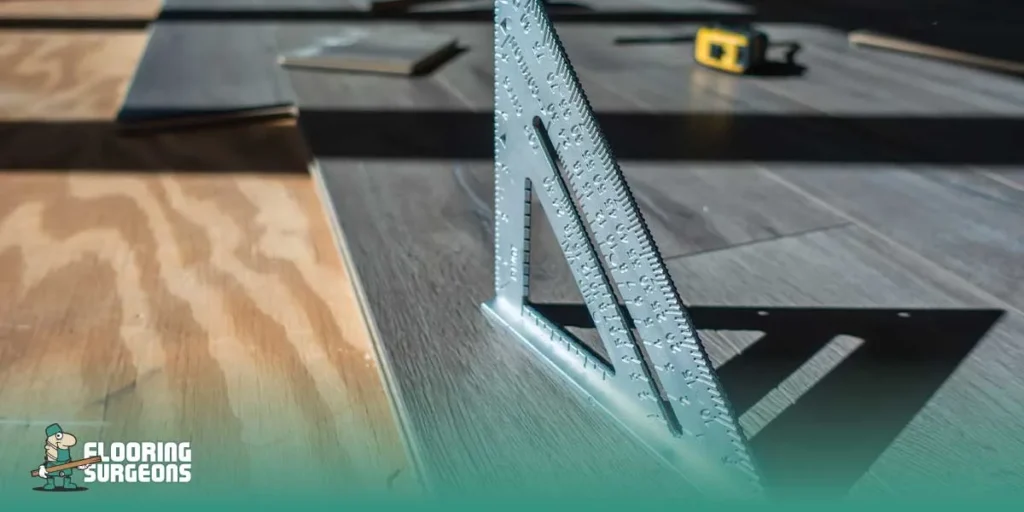

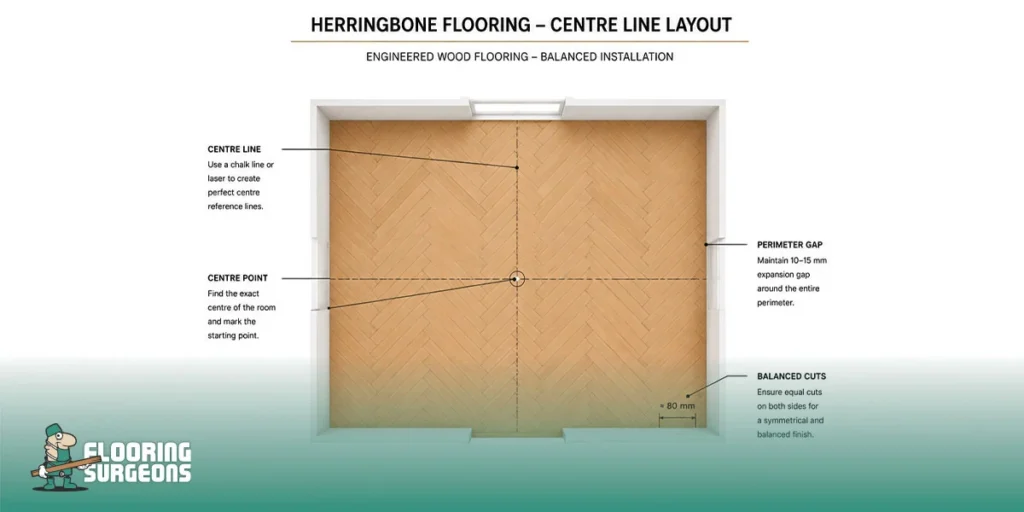

Step 1: Mark the Centre Line
Begin by identifying the exact centre of the room using a tape measure, chalk line, or laser level.
✔ Mark a perfectly straight centre reference line
✔ Check that the room is square before installation
✔ Confirm balanced border widths before fitting begins
✔ Plan perimeter cuts to avoid narrow edge pieces
Accurate centre-line positioning helps keep the herringbone pattern balanced and prevents visible pattern drift during installation.

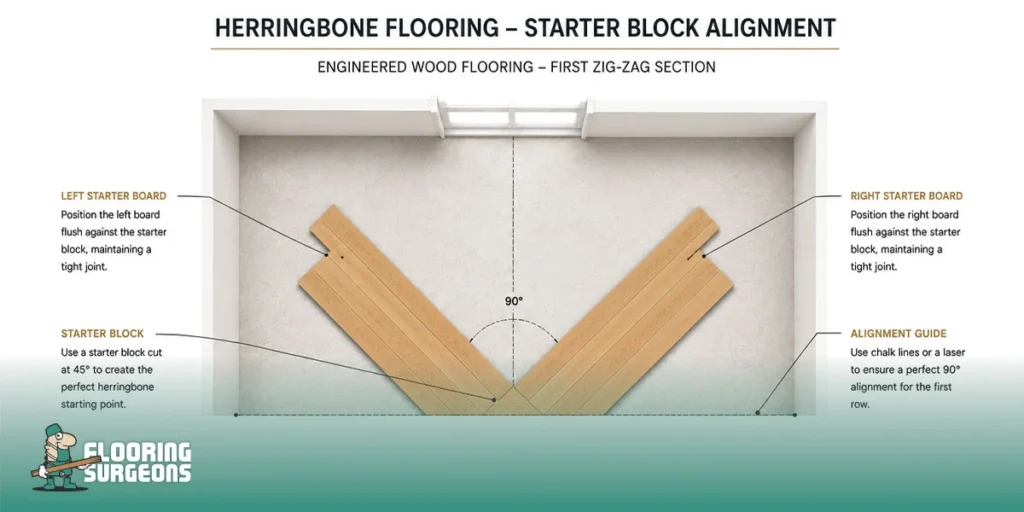

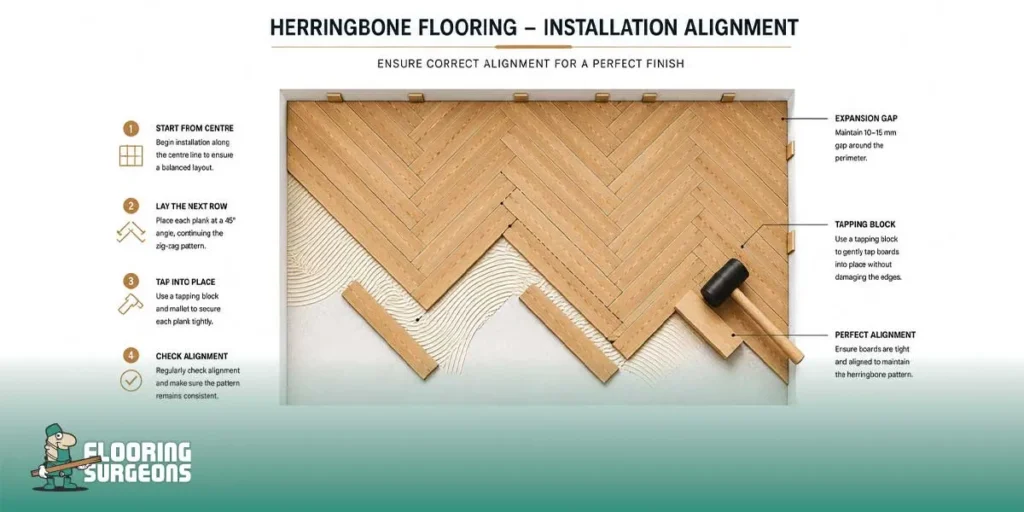

Step 2: Create the Starter Block
Assemble the first herringbone zig-zag section before applying adhesive.
✔ Dry-fit the starter boards first
✔ Ensure the left and right boards align correctly
✔ Check that the first angles remain perfectly square
✔ Use the starter section as the reference point for the floor
Any error within the starter block can affect the alignment of the entire pattern.

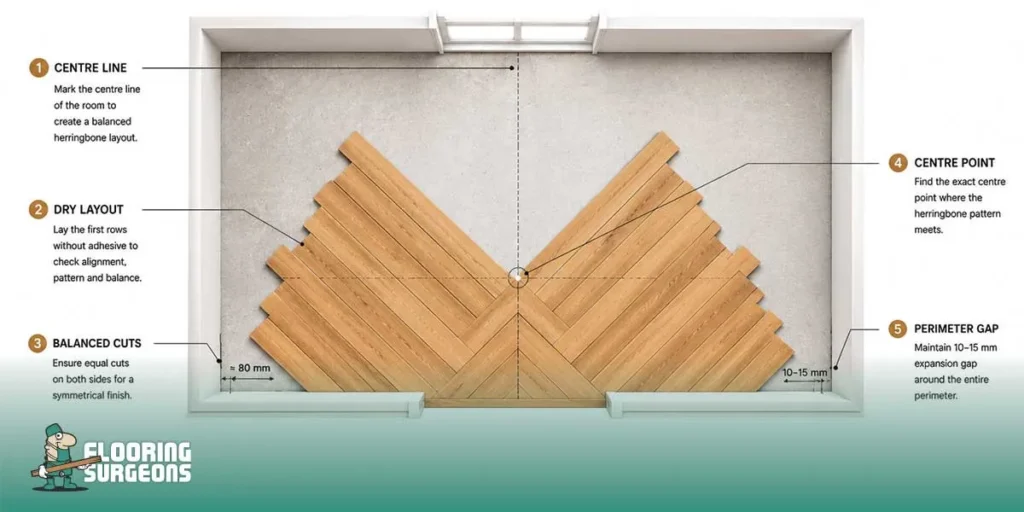

Step 3: Dry-Lay the First Rows
Before permanent installation, dry-lay several rows to confirm the pattern remains centred and aligned across the room.
✔ Check pattern alignment before applying adhesive
✔ Confirm balanced perimeter spacing and border cuts
✔ Avoid narrow edge pieces where possible
✔ Verify the zig-zag layout remains centred throughout the room
Dry-laying the first rows helps identify layout issues before the flooring is permanently fixed.

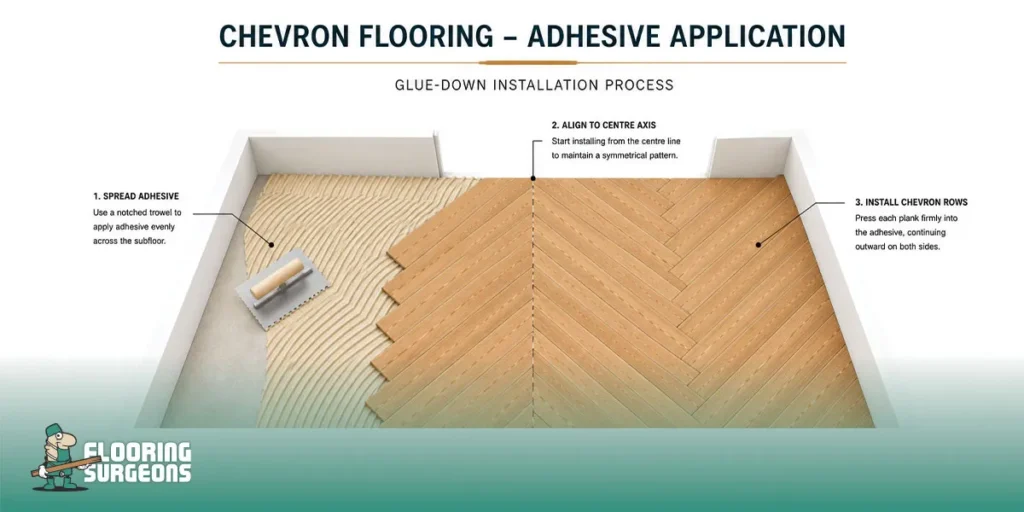

Step 4: Apply Adhesive in Small Sections
Engineered herringbone flooring is typically installed using a full glue-down method.
✔ Apply adhesive evenly using a notched trowel
✔ Work in small sections to prevent adhesive skinning
✔ Maintain clean and consistent adhesive coverage
✔ Remove excess adhesive immediately from board joints
Use a flexible wood flooring adhesive suitable for engineered flooring installations.

Step 5: Build the Herringbone Pattern
Install the boards gradually while checking alignment regularly throughout the installation.
✔ Maintain tight and consistent board joints
✔ Check the centre line frequently during fitting
✔ Use a tapping block carefully to avoid edge damage
✔ Keep the zig-zag pattern aligned across the floor
✔ Remove adhesive residue immediately after fitting
Even small alignment errors can become highly visible across large herringbone floors.

Step 6: Cut Border and Perimeter Pieces
Once the main herringbone pattern is complete, cut and install the perimeter boards around the room edges.
✔ Measure perimeter cuts accurately before trimming
✔ Maintain expansion gaps around fixed objects
✔ Keep border widths visually balanced throughout the room
✔ Use a mitre saw for clean and precise cuts
Balanced perimeter cuts help create a more symmetrical finished layout.

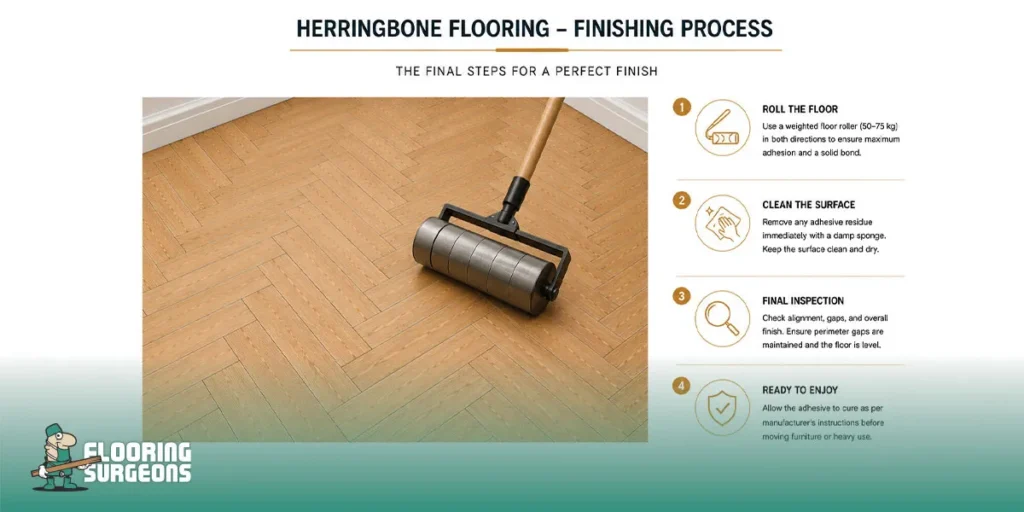

Step 7: Roll and Clean the Floor
After installation, clean the floor thoroughly and allow the adhesive to cure fully before heavy use.
✔ Roll the floor using a weighted floor roller if recommended
✔ Check for loose boards or uneven joints
✔ Remove all remaining adhesive residue immediately
✔ Allow the adhesive to cure before heavy foot traffic
Proper cleaning and curing help ensure a stable and professional-looking finish.

Common Herringbone Installation Mistakes
✔ Incorrect centre-line positioning causing pattern drift
✔ Uneven starter block alignment at the beginning of installation
✔ Installing over an uneven or unstable subfloor
✔ Inconsistent zig-zag spacing between boards
✔ Allowing the adhesive to skin before fitting the boards
✔ Failing to check alignment regularly during installation
Even small installation errors can become highly visible across large herringbone floors.
How to Install Engineered Chevron Flooring
Engineered chevron flooring requires precise layout planning and accurate installation to maintain a clean and symmetrical V-shaped pattern. Unlike herringbone flooring, chevron boards meet point-to-point, making alignment accuracy critical throughout the installation.
Chevron flooring is typically installed using a full glue-down method for maximum stability and pattern consistency.
Step 1: Verify the Chevron Angle
Before installation begins, confirm the chevron angle specified by the flooring manufacturer.
✔ Common chevron angles include 45° and 60°
✔ Ensure all boards use the same matching angle
✔ Check left and right boards before fitting
✔ Avoid mixing different board profiles or angles
Incorrect angle matching can disrupt the entire chevron layout.

Step 2: Mark the Centre Axis
Use a laser level or chalk line to establish the main centre axis before installation begins.
✔ Mark a perfectly straight centre reference line
✔ Check the room squareness carefully
✔ Plan border widths and perimeter cuts in advance
✔ Keep the chevron layout visually balanced across the room
Chevron flooring relies heavily on a perfectly straight starting axis.

Step 3: Dry-Lay the First V Rows
Before applying adhesive, dry-lay several rows to confirm the chevron pattern alignment.
✔ Check that all points align correctly
✔ Verify consistent V-pattern spacing
✔ Confirm balanced perimeter positioning
✔ Ensure the layout remains centred throughout the room
Dry-laying helps identify alignment issues before permanent installation begins.

Step 4: Apply Adhesive Evenly
Chevron flooring is typically installed using a full glue-down method.
✔ Apply adhesive evenly using a notched trowel
✔ Work in small sections to prevent premature drying
✔ Maintain consistent adhesive coverage across the subfloor
✔ Remove excess adhesive immediately from board surfaces
Consistent adhesive coverage helps maintain pattern stability during installation.

Step 5: Install the Chevron Pattern
Install the boards gradually while checking alignment continuously throughout the installation.
✔ Ensure each point meets precisely at the centre
✔ Maintain tight and consistent board joints
✔ Check row alignment frequently using a straight edge or laser
✔ Avoid forcing boards into position
✔ Keep the V pattern symmetrical across the floor
Even small alignment errors can create visible pattern creep across large chevron floors.

Step 6: Install Borders and Perimeter Cuts
After completing the main pattern, install the perimeter boards and border details around the room.
✔ Measure perimeter cuts carefully before trimming
✔ Maintain expansion gaps around walls and fixed objects
✔ Install feature strips or border frames if required
✔ Use a mitre saw for clean angle cuts
Balanced perimeter detailing helps maintain a symmetrical finished appearance.

Step 7: Final Alignment Check and Rolling
Once installation is complete, inspect the floor carefully before allowing heavy use.
✔ Check for open points or uneven joints
✔ Roll the floor if recommended by the adhesive manufacturer
✔ Remove all remaining adhesive residue
✔ Allow the adhesive to cure fully before heavy traffic
Final inspection helps ensure a clean and symmetrical chevron finish.

Common Chevron Installation Mistakes
✔ Incorrect centre-axis positioning causing pattern misalignment
✔ Poor point-to-point alignment between chevron boards
✔ Uneven V-pattern spacing across the floor
✔ Allowing pattern creep during installation
✔ Mixing incorrect chevron board angles or profiles
✔ Uneven adhesive coverage across the subfloor
✔ Inaccurate perimeter cuts or border alignment
Even small alignment issues can become highly visible across large chevron flooring installations.
How to Install Versailles Panel Flooring
Versailles panel flooring requires precise layout planning, accurate panel alignment, and careful subfloor preparation to achieve a symmetrical and balanced finish. Unlike plank flooring, Versailles panels are installed as a repeating grid pattern, making room squareness and layout consistency essential throughout the installation.
Versailles panels are typically installed using a full glue-down method for maximum stability and long-term performance.
Step 1: Check Room Squareness
Before installation begins, check the room carefully to confirm the layout remains balanced across the space.
✔ Measure the room in multiple directions
✔ Check diagonal measurements to confirm squareness
✔ Identify uneven walls or irregular room shapes
✔ Plan border widths and panel positioning in advance
Even small room irregularities can affect the symmetry of the finished panel layout.

Step 2: Dry-Lay the Panel Grid
Dry-lay several panels before applying adhesive to confirm the overall layout and panel positioning.
✔ Check panel alignment and spacing carefully
✔ Balance perimeter cuts around the room
✔ Avoid narrow border sections where possible
✔ Ensure the panel grid remains visually centred
Dry-laying helps identify layout imbalance before permanent installation begins.

Step 3: Mark Reference Axes
Use chalk lines or laser levels to establish the main installation reference axes.
✔ Mark both horizontal and vertical reference lines
✔ Use the grid lines to maintain panel alignment
✔ Recheck measurements regularly during installation
✔ Keep the panel layout square across the room
Accurate reference lines help maintain consistent panel geometry throughout the installation.

Step 4: Apply Full-Spread Adhesive
Versailles flooring should be installed using a high-quality full-spread adhesive system.
✔ Apply adhesive evenly using a notched trowel
✔ Work in manageable installation sections
✔ Maintain consistent adhesive coverage across the subfloor
✔ Avoid gaps beneath the flooring panels
Proper adhesive coverage helps support the size and weight of Versailles panels.

Step 5: Install the Panels
Install the panels carefully while maintaining consistent spacing and alignment throughout the floor.
✔ Position each panel accurately within the grid
✔ Check panel edges and corners regularly
✔ Maintain consistent joint spacing across the floor
✔ Avoid shifting panels once placed into adhesive
✔ Remove adhesive residue immediately after fitting
Minor alignment errors can become highly visible across large Versailles flooring installations.

Step 6: Install Borders and Feature Strips
After the main panels are installed, fit the perimeter sections and decorative border details.
✔ Measure perimeter sections carefully before cutting
✔ Install border frames or feature strips where required
✔ Maintain expansion gaps around walls and fixed objects
✔ Use precision cutting tools for accurate fitting
Balanced borders help create a more symmetrical and refined finished appearance.

Step 7: Final Rolling and Inspection
Once installation is complete, inspect the floor carefully before allowing heavy use.
✔ Roll the floor if recommended by the adhesive manufacturer
✔ Inspect for uneven panels or inconsistent joints
✔ Remove all remaining adhesive residue
✔ Allow the adhesive to cure fully before heavy traffic or furniture installation
Final inspection helps ensure a stable and symmetrical Versailles flooring finish.

Common Versailles Installation Mistakes
✔ Installing panels in an uneven or out-of-square room
✔ Incorrect panel grid alignment across the floor
✔ Uneven perimeter spacing or border widths
✔ Inconsistent joint spacing between panels
✔ Uneven adhesive coverage beneath large panels
✔ Failing to maintain straight reference axes during installation
✔ Inaccurate border or feature strip fitting
Even small alignment inconsistencies can affect the symmetry of large Versailles flooring layouts.
Common Engineered Flooring Installation Mistakes to Avoid
Most engineered wood flooring issues are caused by incorrect installation rather than manufacturing defects. Proper subfloor preparation, accurate layout planning, and regular alignment checks help ensure a stable and professional finish.
| Installation Mistake | Common Cause | Possible Result |
|---|---|---|
| Poor subfloor levelling | Uneven screed or plywood | Hollow areas and floor movement |
| Incorrect moisture control | Excess subfloor moisture | Expansion, cupping, or adhesive failure |
| Inaccurate centre-line layout | Incorrect measuring or alignment | Pattern drift and uneven borders |
| Insufficient expansion gaps | Tight perimeter fitting | Buckling or floor lifting |
| Uneven adhesive coverage | Incorrect trowel application | Loose boards or hollow spots |
| Misaligned chevron points | Poor layout control | Uneven V-pattern alignment |
| Incorrect herringbone starter block | Inaccurate starting position | Off-centre pattern layout |
| Uneven Versailles grid alignment | Poor room balancing | Asymmetrical panel appearance |
| Allowing adhesive to dry too quickly | Working in large sections | Weak adhesive bonding |
| Forcing boards into position | Incorrect board alignment | Damaged joints or board edges |
Decorative layouts such as herringbone, chevron, and Versailles flooring require continuous alignment checks throughout the installation process.
Post-Installation Care & Curing Time
Proper aftercare helps engineered wood flooring remain stable, secure, and visually consistent after installation. Adhesives and environmental conditions should stabilise fully before the floor is exposed to heavy use or temperature changes.
| After-Installation Step | Recommended Timing |
|---|---|
| Light foot traffic | 12–24 hours |
| Heavy furniture placement | 24–48 hours |
| Rugs and mats | 48–72 hours |
| Underfloor heating restart | Gradual increase after 7 days |
| Full adhesive cure | Typically 48–72 hours |
Important Aftercare Tips
✔ Avoid dragging heavy furniture across the floor
✔ Use felt pads beneath furniture legs
✔ Maintain stable room temperature and humidity levels
✔ Remove adhesive residue immediately after installation
✔ Avoid sudden temperature changes, especially with underfloor heating systems
✔ Avoid excessive water exposure during the first few days after installation
For underfloor heating systems, increase the temperature gradually over several days to minimise stress on the engineered wood flooring and adhesive system.

Conclusion
Installing engineered wood flooring correctly is essential for achieving a stable, durable, and visually balanced finish. While straight plank flooring is generally more forgiving, decorative layouts such as herringbone, chevron, and Versailles panels require precise layout planning, accurate alignment, and careful installation throughout the fitting process.
Successful installation depends on proper subfloor preparation, moisture control, expansion spacing, adhesive selection, and regular alignment checks. Even small installation errors can become highly visible within decorative flooring patterns.
With correct installation and stable environmental conditions, engineered wood flooring can provide long-term durability, structural stability, and a premium natural wood appearance for many years.
For homeowners comparing flooring options before installation, our guide on “Is Engineered Wood Better Than Laminate?” explains the key differences between both flooring types.
For professional advice, site preparation, or engineered wood flooring installation support, Flooring Surgeons can help.
Mina Asgari
I’m an SEO Specialist and Content Strategist focused on sustainable business growth. I design data-driven content strategies by deeply analyzing user intent, search behavior, and SEO best practices, ensuring every piece of content serves a clear purpose for both users and search engines.
